The Klang Valley Factory Moving Checklist:

How to Prepare for a Major Machine Move

Executive Summary

Moving a factory in the Klang Valley is an operational minefield. In hubs like Shah Alam, Balakong, or Port Klang, a single day of unexpected downtime can leak tens of thousands of ringgit in unfulfilled supply chain contracts.

Most plant managers approach relocation purely as a logistical challenge—hiring a lorry and some riggers. That is an expensive mistake. A successful move requires an equal balance of mechanical precision, data protection, and absolute compliance with strict Malaysian statutory bodies. If you move a heavy stamping press or an overhead crane without updating your government certifications, you face crushing legal fines before the machine even plugs into the grid.

This guide details the exact operational checklist of machine moving to protect margins and maintain regulatory compliance.

Phase-by-Phase Machine Moving Checklist

Moving industrial assets requires a strict timeline. Misordering these steps leads to structural damage or sudden legal shutdown notices.

1)The Engineering & Floor Audit (3 Months Out.) Verify that the concrete slab thickness at your new facility can handle the concentrated static and dynamic loads of your heaviest machinery. Check with your landlord or structural engineer for the factory blueprint’s floor load capacity, and ensure the access doors can clear your rigging equipment’s turning radius.

2)Digital Logic Backups (2 Months Out.) Before any technician touches a main power switch, pull complete system backups of all programmable logic controllers (PLCs), human-machine interfaces (HMIs), variable frequency drives (VFDs), and robotics files. Hard drives should be individually removed and transported in anti-static packaging separate from the heavy chassis.

3)The Deconstruction Mapping (1 Month Out.) Do not trust original factory blueprints—field modifications made over the years are rarely documented. Photograph every single terminal layout, label both ends of every electrical wire with matching terminal numbers, and create a comprehensive cable schedule before disconnecting utility lines.

4)The Regulatory Filings Trigger (2-4 Weeks Out.) Submit your relocation and alteration applications to local authorities and utility boards. This includes your local town council (PBT) premise licenses, Department of Occupational Safety and Health (DOSH/JKKP) portal updates, and Tenaga Nasional Berhad (TNB) 3-phase power load activations.

5)The Precision Reassembly & Calibration (Post-Move Week 1.) Position the equipment according to pre-planned workflow lines to eliminate unnecessary operator travel time. Anchor and grout the bases, verify that all electrical ground connections are safely bonded, re-test every safety interlock at low speed, and run your first test parts against original cycle time metrics.

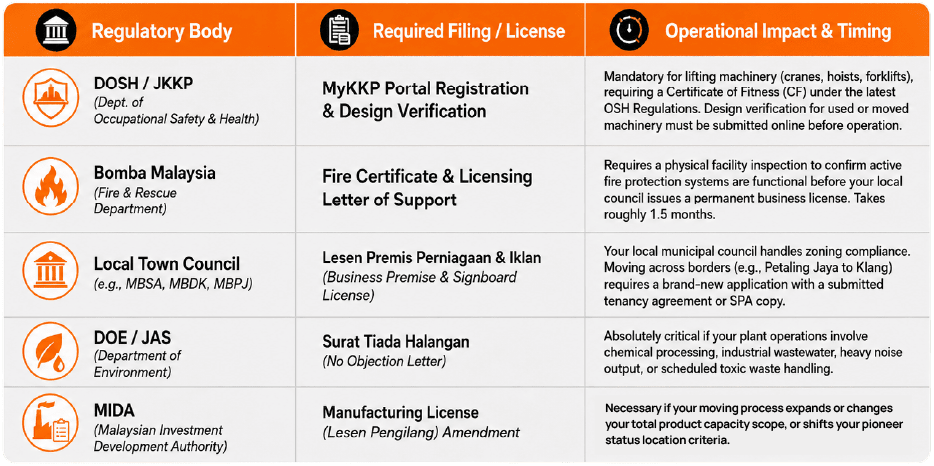

The Malaysian Regulatory Compliance Matrix

Operating industrial machinery in Malaysia requires navigating a web of state and federal approvals. Moving your factory means you must update or re-apply for these licenses completely from scratch.

The "Hidden Breakdown" Tax of Poor Mapping

The Troubleshooting Trap: Legacy machines often feature decades of undocumented, hand-wired structural modifications. If your decommissioning crew cuts through a control wiring loom without labeling individual conductors, your assembly technicians will face days of tedious circuit troubleshooting. This single oversight can extend your planned operational downtime from two days to two weeks.

To prevent this, ensure your moving contractor utilizes clear physical tagging and visual mapping. Every line—whether electrical, pneumatic, or hydraulic—must have matching identifiers at both the origin and destination terminals before the machine is lifted onto a low-loader truck.

The Final Inspection: Plan the Move, Protect the Margin

At the end of the day, a successful factory moving isn’t measured by how fast the machinery arrives at the new site. It is measured by how quickly your production lines return to full capacity, hitting peak throughput with zero unexpected defects.

Treating your machinery move like a simple transport job is a guaranteed recipe for prolonged downtime, broken components, and stressful legal compliance battles with DOSH or local town councils. By systematically walking through floor load audits, securing digital logic backups, mapping every wire, and front-loading your regulatory paperwork, you protect your company’s operational margins from the moment the low-loader trucks roll out.

Moving your facility is a massive milestone. Do it right, do it safely, and give your business the precision foundation it needs to thrive in its next chapter of growth across the Klang Valley.
